ARC is Planning for the Future!

Mobility 2055: Metro Atlanta on the Move

ARC is developing Mobility 2055, metro Atlanta's long-range blueprint to guide transportation investments through 2055.

Description of the image

Mobility 2055 will shape how federal and state funding is invested across metro Atlanta to improve roads, transit, and active transportation to address growth, improve mobility, and strengthen the economy. This major update of the Atlanta Metropolitan Transportation Plan (MTP) will include the Transportation Improvement Program (TIP), the region's short-term list of priority transportation projects that are expected to use federal funding over the next four years.

Why the MTP matters

As the federally designated Metropolitan Planning Organization (MPO) for the Atlanta region, ARC coordinates the development of the MTP in close collaboration with the state of Georgia, 19 counties, the region's transit agencies, the City of Atlanta, and dozens of smaller cities and nonprofit organizations.

Map of the 19-county metro Atlanta including: Barrow, Carroll (partial), Cherokee, Clayton, Cobb, Coweta, Dawson (partial), DeKalb, Douglas, Fayette, Forsyth, Fulton, Gwinnett, Henry, Newton, Paulding, Rockdale, Spalding, and Walton (partial)

As the federally designated Metropolitan Planning Organization (MPO) for the Atlanta region, ARC coordinates the development of the MTP in close collaboration with the state of Georgia, 19 counties, the region's transit agencies, the City of Atlanta, and dozens of smaller cities and nonprofit organizations.

Mobility 2055 plays a vital role in shaping how people and goods move throughout metro Atlanta. As the region continues to grow, thoughtful long-term planning is essential to reduce congestion, improve safety, and expand transportation options.

By aligning investments with regional goals, Mobility 2055 helps:

  • Support economic development and job access
  • Enhance connectivity between communities
  • Promote environmental sustainability and resilience
  • Improve safety for all users of the transportation system

Ultimately, Mobility 2055 will ensure that transportation decisions made today will meet the needs of tomorrow’s residents, businesses, and visitors.

How Mobility 2055 will align with regional priorities

Mobility 2055 will closely align with the ARC’s broader planning efforts to ensure a coordinated, forward-looking approach to growth and infrastructure. It works in tandem with key regional initiatives, including the Regional Development Plan, the (Walk, Bike, Thrive!), the Regional Freight Mobility Plan, the Metro Atlanta Climate Action Plan, and many more, to create a more connected, sustainable, and resilient region.

By integrating these efforts, Mobility 2055 will support improved air quality for the region through initiatives such as: expanding multimodal transportation options, guiding future land use, reducing greenhouse gas emissions, and advancing climate and environmental goals. This alignment ensures that transportation investments not only improve mobility, but also reinforce the region’s long-term vision for livability, health, and economic prosperity.

How Mobility 2055 will engage with the public

Public engagement is a critical component of developing Mobility 2055, ensuring that the plan reflects the needs, priorities, and values of the region’s residents and stakeholders. Engagement will occur in four key phases throughout the planning process:

  1. May – September 2026

    Phase 1: Project Kickoff and Transportation Needs

    Introduces the MTP process and gathers input on current transportation challenges, needs, and opportunities across the region.

  2. October 2026 – February 2027

    Phase 2: Scenario Development and Impact

    Engages the public in exploring different future scenarios and understanding how various investment strategies could impact mobility, communities, and the environment.

  3. March – September 2027

    Phase 3: Draft Recommendations Feedback

    Presents proposed projects and strategies, providing opportunities for stakeholders to review and share feedback to help refine the plan.

  4. October 2027 – February 2028

    Phase 4: Plan Review and Validation

    Shares the near-final plan and confirms that it reflects community input, ensuring transparency and accountability before adoption.

Through each phase, the MTP emphasizes inclusive and accessible engagement to capture diverse perspectives and build a shared vision for the region’s transportation future.

Mobility 2055: Plan Development Schedule

Mobility 2055 will be presented to the TAQC and ARC Board in early 2028 for adoption. Over the next several months, the project team will be working on various tasks and engaging with diverse stakeholders on this major MTP update!

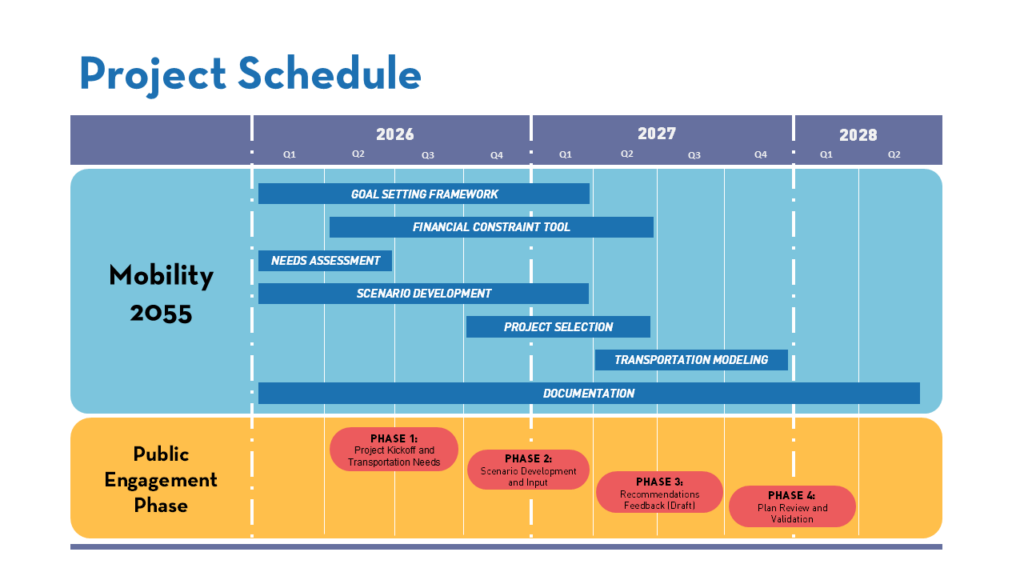

A project schedule Gantt chart titled "Project Schedule," spanning Q2 2026 through Q2 2028. The top timeline row shows the Mobility 2055 workstream with overlapping bars for Goal Setting Framework (Q2 2026–Q3 2027), Financial Constraint Tool (Q3 2026–Q1 2027), Needs Assessment (Q2–Q3 2026), Scenario Development (Q2 2026–Q1 2027), Project Selection (Q4 2026–Q2 2027), Transportation Modeling (Q2–Q4 2027), and Documentation running the full length (Q2 2026–Q1 2028). Below it, the Public Engagement Phase row shows four rounded callout bubbles: Phase 1 – Project Kickoff and Transportation Needs (Q2–Q3 2026); Phase 2 – Scenario Development and Input (Q4 2026–Q1 2027); Phase 3 – Recommendations Feedback (Draft) (Q2–Q3 2027); Phase 4 – Plan Review and Validation (Q4 2027–Q1 2028).

Questions or Comments about this MTP update?

Please reach out to our engagement team at [email protected] with any questions or comments related to Mobility 2055.

2050 Metropolitan Transportation Plan

For additional information on the currently approved MTP (adopted in February 2024), please refer to the Metropolitan Transportation Plan page.
